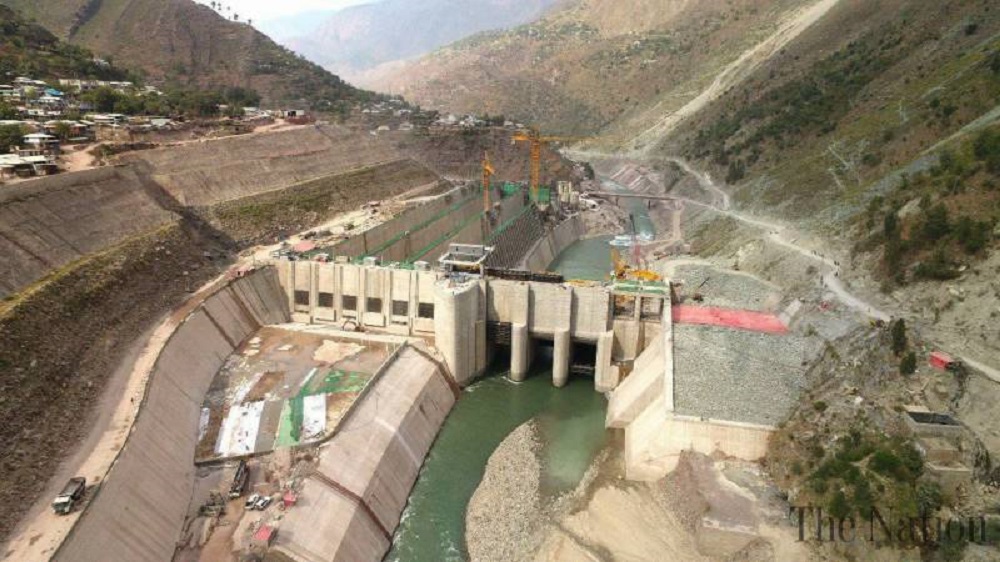

CGGC working nonstop on remedial works of Neelum Jhelum HP

ISLAMABAD: China Gezhouba Group Company (CGGC) is carrying remedial works day and night at Tail Race Tunnel of the Neelum Jhelum Hydropower Project NJHP), according to a report published by Gwadar Pro.

The Electricity generation from NJHP had to suspend in July 2022 due to blockage at one location of the Tail Race Tunnel, out of the project’s tunneling system which is about 68 Kilometers long.

Chairman WAPDA Lt Gen Sajjad Ghani (Retd) visited Neelum Jhelum Hydropower Project on Friday and reviewed progress on remedial works in Tail Race Tunnel of the project.

The Chief Executive Officer of Neelum Jhelum Hydropower Company (NJHC) and representatives of the CGGC and the consultants were also present on the occasion.

WAPDA had awarded the remedial contract to CGGC in August 2022 after seeking approval from the federal government. Since then, the remedial works are being carried out day and night at the site.

While witnessing the construction work at the site in the Tail Race Tunnel, the Chairman emphasized upon the project management to complete the remedial works in accordance with the schedule. He further directed that recommendations made by the International Panel of Experts be also adhered to in carrying out the remedial works.

Earlier in a briefing, Chief Executive Officer NJHC apprised the Chairman about progress achieved so far on the remedial works.

The 969 MW-NJHP started electricity generation in April 2018. Prior to suspension of electricity generation in July 2022, the project had provided more than 18 billion units of electricity to the National Grid.
